A half-bath addition in the U.S. averages approximately $6,500, but real projects have ranged from $3,800 to $25,000. The cost of adding a half bathroom depends far more on plumbing distance, structural access, and code work than on the toilet and sink themselves.

That spread matters in Northern Colorado, where a powder room tucked beside an existing bathroom can be a manageable conversion, while a room over a concrete slab may require demolition, drainage work, vent routing, inspections, and structural coordination. A national benchmark helps you start, but it won't tell you what your house will really cost.

A powder room contains fewer fixtures than a full bathroom, but it still needs a legal drain, water supply, venting, electrical work, ventilation, finished walls, and a permitted installation. The right first question isn't “What does a half bath cost?” It's “How close is the proposed room to usable plumbing, and what has to be opened to reach it?”

What a Half Bathroom Actually Costs in 2026

The 2025 remodeling report places bathroom work at roughly $230 to $550 per square foot, but that benchmark cannot price a powder room by itself. A nearby conversion may stay controlled, while a room that requires long drain runs, slab cutting, or an exterior addition can move into a completely different budget. Review the National Association of REALTORS® remodeling report for national context, then have a local contractor price the actual access and code work.

A half bath costs less than a full bathroom because it has no shower or tub. You avoid waterproofing, shower drainage, and much of the wet-area finish work. The toilet drain, vent connection, electrical access, ventilation, and wall repairs still determine the estimate.

The three scope buckets that control the estimate

Nearby conversion: A closet or existing room beside a bathroom, kitchen, or plumbing wall is usually the most predictable option. The toilet and sink can connect with limited demolition, and the existing footprint avoids new exterior construction. This is the scope to choose when keeping the budget disciplined matters most.

Mid-distance conversion: A hallway niche, under-stair area, or room across finished space requires longer pipe routes and more wall or ceiling access. Expect added coordination for drain slope, vent routing, patching, and finish repairs. The room may look simple after completion, but the concealed work drives the price.

Structurally complex addition: A basement installation, slab-cut project, or new exterior room introduces the most variables. Framing, foundation or concrete work, drainage changes, insulation, fire separation, and additional inspections can all affect the bid.

A published plumbing cost guide for adding a bathroom also shows why distance from the existing system matters more than the fixture package. A standard toilet and sink rarely create the largest cost swing. Opening the house and restoring it does.

Choose finishes after the scope is clear. A practical tier uses stock fixtures, a compact vanity or pedestal sink, standard lighting, and painted drywall. A polished tier adds a furniture-style vanity, upgraded faucet, better lighting, and limited tile. A luxury tier may include a wall-hung toilet, custom millwork, premium fixtures, and specialty tile. For broader planning context, see this cost guide for adding a bathroom.

For Northern Colorado homeowners, request separate pricing for nearby conversion, mid-distance conversion, and structurally complex addition. That comparison reveals whether the proposed location is saving money or creating the project.

Itemized Cost Breakdown for Every Component

A reliable half-bath estimate separates visible fixtures from the work behind the wall. For Northern Colorado projects, plumbing distance and access usually matter more than the toilet or sink selected. Review every line against the project's scope bucket: nearby conversion, mid-distance conversion, or structurally complex addition.

What belongs in the estimate

Component Typical Cost Range What Drives the Price
Toilet and sink Fixture selection varies widely Floor-mounted fixtures usually simplify installation. Wall-hung toilets, specialty faucets, and designer sinks add blocking, coordination, and installation time
Plumbing rough-in Scope-dependent Labor, materials, access, drain slope, vent routing, and restoration drive the price. Long pipe runs are not the only concern. Concrete, finished flooring, tight joist bays, and limited access can add labor. For national totals, see these plumbing benchmarks
Supply and waste modifications Highly site-dependent Pipe condition, replacement length, fitting count, and connection points determine the allowance. Reported pipe-replacement costs range from approximately $150 to $5,800, depending on the work required. National remodeling data
Electrical Scope-dependent Lighting, switches, GFCI protection where required, wiring access, and circuit capacity affect the bid
Ventilation Scope-dependent The fan itself is only one part. Price also reflects duct length, exterior termination, roof or wall penetration, air-sealing, insulation coordination, and firestopping
Framing and drywall Scope-dependent New partitions, door openings, load-bearing conditions, drywall finishing, and protection of adjacent rooms affect labor
Flooring and finishes Selection-dependent Vinyl, tile, trim, paint, wallpaper, countertop material, hardware, and installation complexity separate practical finishes from polished or luxury specifications
Permits and inspections Local schedule applies Plumbing, electrical, building, ventilation, and structural reviews may apply. One published estimate places permit fees at approximately $500 to $1,500, though local fees vary. Bathroom permit and resale context

Labor may appear inside each category rather than as one separate line. That is normal in a design-build contract, but the proposal should identify responsibility for demolition, rough plumbing, electrical work, drywall, finish installation, and inspection coordination.

Practical rule: If the estimate lists only fixtures and visible finishes, it does not price the concealed work clearly enough.

Exhaust routing deserves its own line. Under common IRC-based requirements, a bathroom without a qualifying operable window generally needs mechanical exhaust delivering 50 CFM intermittently or 20 CFM continuously, discharged outdoors. A qualifying natural-ventilation path generally requires at least 3 square feet of window area, with at least half openable. Review the IRC bathroom ventilation requirements and confirm the locally adopted code edition.

Demolition also changes the allowance. A remodel may preserve existing walls and plumbing, while a new room can require removal, framing, drain work, venting, electrical installation, permits, and inspections. Review this guide to bathroom demolition costs before accepting a low fixture-only estimate.

Comparing a Closet Conversion to a New Addition

The location of the existing drain and vent system usually matters more than the room's finish level. A nearby conversion can keep plumbing short and walls intact. A remote addition may require concrete work, structural changes, and longer mechanical runs before the vanity or toilet is installed.

Nearby conversion

A closet or under-stair conversion is the first option I investigate. Existing walls can often remain, supply lines stay short, and exterior construction may be unnecessary. The design still has to fit the toilet, sink, door swing, lighting, ventilation, and required clearances without making the room uncomfortable.

Keep the toilet close to the existing plumbing. Moving it for a slightly better-looking arrangement can turn a straightforward conversion into a demolition and repiping project.

Mid-distance conversion

A hallway or interior-space conversion can work when the plumbing stack is nearby but not directly adjacent. Expect some finished-wall or floor opening, a new partition, drain-slope planning, and concealed vent routing. The room may look simple after completion, but the access work determines the estimate.

Before accepting a firm construction price, have the contractor verify joist direction, wall construction, access panels, and the likely pipe route. Drawings and limited exploratory inspection are worthwhile because they replace assumptions with conditions the crew can price accurately.

Structurally complex addition

A basement, garage, attic, or remote first-floor location belongs in the highest-risk scope bucket. Concrete-slab cutting, trenching, long drain and vent runs, new framing, structural review, and difficult material access can all apply. As noted earlier, slab work and long plumbing routes drive the high end of the budget. Review the national cost benchmarks here.

Scope bucket Best fit Primary risk
Nearby conversion Closet, hallway niche, or under-stair space near existing plumbing Tight dimensions and ventilation routing
Mid-distance conversion Existing room needing new walls and a moderate pipe run Finished-surface demolition and drain slope
Structurally complex addition Basement, slab installation, garage, attic, or exterior expansion Concrete, structural work, long mechanical runs, and expanded permit review

Choose the location by mechanical feasibility first, then by appearance. Spend the first design meeting proving that the drain, vent, access, and clearances work. Select the vanity, mirror, and finish package after the scope bucket is clear. That sequence gives you a more reliable estimate and shows whether the project belongs in a practical, mid-range, or high-complexity budget.

Hidden Expenses That Blow Up the Budget

The budget usually doesn't fail because someone chose the wrong faucet. It fails because the initial estimate treated difficult access as if it were a cosmetic renovation.

Venting is a common example. An interior powder room may need ductwork through an attic or wall cavity, an exterior termination, insulation coordination, and firestopping. Electrical work can also expand when the existing circuit layout doesn't support the required bathroom lighting, fan, or GFCI protection.

Concrete is another major dividing line. A toilet drain below a slab may require demolition, excavation, pipe installation, backfill, concrete repair, and finish replacement. A crawlspace can simplify access, but it doesn't eliminate the need to verify clearances, slope, support, and code compliance.

Hidden Expense Typical Trigger Cost Range
Exhaust duct routing Interior room without a qualifying operable window Site-specific, based on duct length, access, and exterior termination
Electrical corrections No suitable circuit, outdated wiring, or required GFCI protection Site-specific
Slab and concrete work New drain below a finished concrete floor Site-specific and potentially substantial
Structural work Load-bearing wall, joist conflict, or new opening Site-specific
Subfloor or joist repair Water damage or damaged framing discovered after demolition Site-specific
Permit and inspection changes Revised scope, failed inspection, or jurisdictional requirements Local schedule and project scope apply

A published bathroom estimate placed permit fees at approximately $500 to $1,500, but local schedules vary. Inspections commonly occur at rough plumbing and electrical stages and again at completion, so a failed inspection can affect both labor sequencing and finish installation. The bathroom permit cost guide offers additional planning context, but your contractor should confirm the actual jurisdictional requirements.

Set aside a contingency before demolition, not after the first surprise. The exact allowance should reflect the age of the house, access conditions, and whether the floor or walls must be opened. If you're also evaluating the broader ownership budget, this resource on PMI and maintenance costs explained is useful because a new bathroom adds ongoing maintenance responsibilities alongside the construction cost.

Ask specifically about what happens if the drain route conflicts with a beam, if the subfloor is damaged, or if the inspector requires a correction. A strong proposal doesn't promise that surprises won't happen. It identifies how the team will document, price, and approve them.

Practical, Polished, and Luxury Budget Tiers

Choose a finish tier before requesting bids. Otherwise, one contractor may price a basic pedestal sink while another includes a custom vanity, and both estimates will appear misleadingly comparable.

Practical

A practical powder room keeps the existing footprint and favors readily available products. Use a standard floor-mounted toilet, stock vanity or pedestal sink, durable vinyl flooring, painted drywall, simple trim, basic lighting, and an exterior-ducted exhaust fan where required.

The best place to cut decorative complexity is not installation quality. Keep the toilet location, avoid complicated tile patterns, and select fixtures with replacement parts that local supply houses can source.

Polished

A polished room improves the pieces homeowners see and touch every day. Consider a mid-range faucet, porcelain floor tile, a semi-custom vanity, better task lighting, a humidity-sensing exhaust fan, upgraded mirror, and carefully selected hardware.

The labor premium comes from coordination and finish precision. Tile layout, cut planning, vanity installation, lighting placement, and trim details need to align. Spend here if the room sits near the entry, serves guests often, or will remain in the home for years.

Luxury

Luxury is more than an expensive faucet. It can include a designer toilet, custom vanity, large-format porcelain or natural stone, premium hardware, a statement mirror, layered lighting, smart ventilation, and in-floor heating where the construction conditions support it.

Category Practical Polished Luxury
Toilet Standard floor-mounted model Comfort-focused or upgraded model Designer or wall-hung system where appropriate
Sink and vanity Stock vanity or pedestal Semi-custom vanity with upgraded counter Custom millwork and premium surface
Flooring Durable vinyl or basic tile Porcelain tile with planned layout Large-format porcelain or natural stone
Lighting Simple ceiling or vanity fixture Layered lighting with improved task illumination Architectural or statement lighting
Ventilation Basic compliant exhaust Humidity-sensing fan Smart fan with carefully concealed ductwork
Special features Minimal decorative tile Better mirror and hardware Heated floor, custom details, premium finishes

Buy durability, layout quality, and ventilation first. Cut the statement mirror, imported hardware, or elaborate tile pattern before cutting the plumbing inspection, electrical compliance, or waterproofing-related work.

Realistic Timeline and Inspection Milestones

A straightforward conversion can move quickly once materials and permits are ready. A new addition takes longer because the crew must coordinate more trades, more inspections, and more unknown conditions.

The planning sequence typically looks like this:

  1. Week 1: Consultation, measurements, plumbing investigation, layout decisions, and 3D pre-visualization.
  2. Weeks 2 to 3: Proposal review, contract signing, fixture selection, and permit submission.
  3. Weeks 3 to 4: Permit processing, material ordering, and final construction planning.
  4. Weeks 4 to 6: Demolition, framing, rough plumbing, rough electrical, ventilation work, and rough inspections.
  5. Weeks 6 to 7: Drywall, flooring, tile, trim, and finish installation.
  6. Week 8: Vanity and fixture setting, electrical trim, paint, punch list, final inspection, and walkthrough.

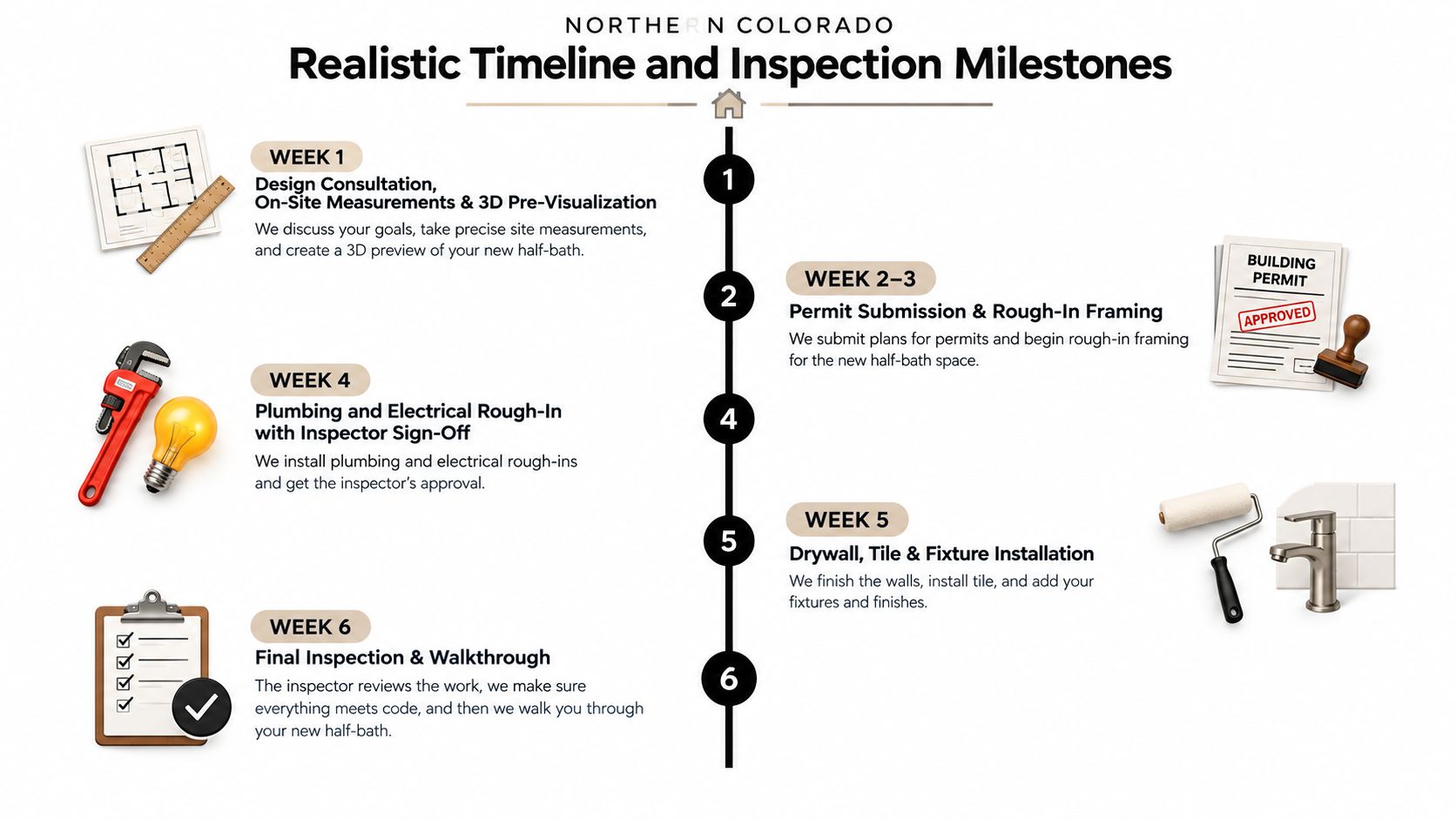

A step-by-step timeline infographic showing the six-week process for adding a half-bathroom to your home.

That sequence can compress when the room is already framed, the plumbing route is short, permits move promptly, and selected products are in stock. A slab installation or exterior addition can stretch well beyond the standard sequence because concrete work, structural review, long mechanical runs, and weather-sensitive construction add coordination.

Inspector availability matters. So do tile lead times, vanity delivery, fixture backorders, and the availability of the supply house's preferred products. Don't schedule demolition until the contractor has confirmed the permit path and ordered the items that could stop finish work.

For a visual explanation of the construction process, this half-bathroom project timeline video can help you understand where rough work ends and finish work begins.

Resale Value and ROI You Can Realistically Expect

A half bath earns its resale value by solving a daily inconvenience. Buyers notice it when guests can use the main floor without entering a private bathroom, or when the home has too few bathrooms for its bedroom count. It is not an automatic profit center, and a powder room rarely justifies an expensive addition on resale potential alone.

Broader remodeling benchmarks can provide context, but they do not predict a powder-room return. A midrange bathroom renovation costing approximately $20,420 and returning approximately $13,717, or 67.2%, covers a broader project category. It does not isolate the plumbing distance, structural work, or compact finish package that determine a half-bath estimate. Review the broader resale discussion here.

What appraisers and buyers can recognize

Functional value carries more weight than decorative spending. A permitted bathroom with documented inspections, sound drainage, durable finishes, and a sensible location gives buyers a clear benefit they can use and verify. A costly vanity or designer tile cannot repair a poor layout, difficult access, or unpermitted work.

Project Type Typical Cost Avg. Resale Recoup Buyer Appeal Driver
Nearby powder-room conversion Lower when existing space and nearby plumbing are reused Project-specific Convenient guest access and better daily function
Mid-distance conversion Higher because access and pipe routing become more involved Project-specific Adds a bathroom without expanding the footprint
Structurally complex addition Highest because drainage, slab, framing, or exterior work may be required Project-specific Resolves a meaningful bathroom shortage when the market supports it

The three scope buckets matter to resale logic. A nearby conversion can deliver strong functional value without a large footprint change. A mid-distance conversion may still make sense when it adds a needed bathroom while controlling structural work. A structurally complex addition needs a clear household benefit, because its higher cost can outpace the value buyers assign to one compact bathroom.

Northern Colorado resale contribution depends on the home's existing bathroom count, neighborhood expectations, household profile, and comparable sales. Ask a local real estate professional to compare similar homes with and without a legal powder room, rather than relying on a national average. Edinhart Realty and Property Management insights offer another perspective on how buyers assess bathroom improvements.

My recommendation is direct. Build the half bath to improve how the household uses the home, then count resale value as a secondary benefit. Invest first in location, permits, drainage, ventilation, and durable finishes. Skip luxury upgrades that do not improve function, and do not assume a structurally complex addition will return every dollar at closing.

What to Ask During Your First Contractor Consultation

Bring a floor plan, photos of the proposed location, and a clear spending target. The first meeting should determine which scope bucket applies, not merely produce a flattering finish board.

Ask the contractor to show the likely plumbing route. You need to know where the nearest stack is, whether the toilet can drain by gravity, how the vent will reach the exterior, and which finished surfaces will be opened. If the room is below grade or over a slab, ask how the team will inspect and price the concrete and drainage conditions before finalizing the scope.

Questions that expose an incomplete estimate

Review the 3D pre-visualization carefully. It should show the door swing, vanity scale, toilet position, lighting intent, colors, and major materials. A polished rendering is not a substitute for a construction plan, but it can expose a cramped layout before demolition begins.

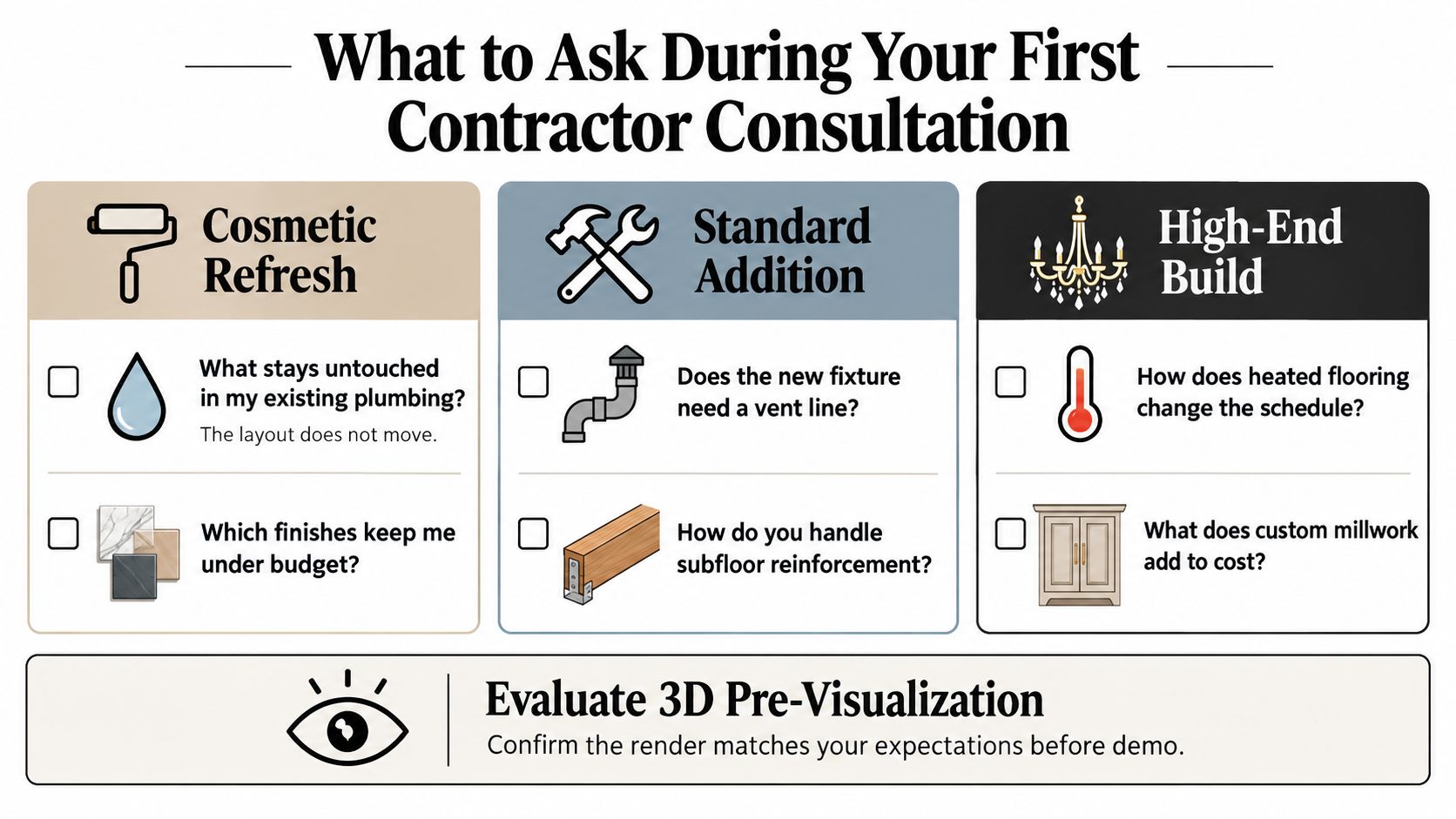

A helpful infographic showing key questions to ask a contractor during home renovation project consultations.

Red flags include a bid with no plumbing route, no ventilation plan, no permit responsibility, no inspection sequence, or no explanation of what happens when concealed conditions change. A thorough Northern Colorado consultation should leave you with a proposed location, preliminary scope, finish assumptions, permit approach, schedule logic, and a written method for controlling changes.


SouthRay Kitchen & Bath helps Northern Colorado homeowners plan half-bath additions with design consultation, a free 3D pre-visualization, fixture and finish selections, and construction coordination across plumbing, electrical, demolition, and installation. Visit SouthRay Kitchen & Bath to request an estimate and compare a practical, polished, or luxury approach before committing to construction.
